VoIP Migration Planner for UK Businesses
Plan a Safer Business Phone Cutover With Clear Evidence
Track business numbers, line-dependent equipment, supplier confirmations, tests and recovery before changing phone services. Create a cutover readiness record and supplier handover pack without signing up.

Know What Must Be Ready
Account for every critical number and line-dependent device. Track named owners, supplier evidence and verified customer call routes before the proposed cutover.
Decision rule: An unresolved safety-related dependency or business-critical number should stop the affected cutover.
Prepare a Business-Specific Cutover Plan
Can your business move phone services without overlooking essential lines? A plan is useful only when the numbers, equipment, owner responsibilities, tests and recovery actions are actually recorded.
Use the interactive planner below to identify blockers and produce a handover pack for the relevant business decision-maker and suppliers.
What the Planner Delivers
Critical dependency register: business numbers, alarms, lift and telecare systems, network, power and call routes.
Named task owners: status, due date and explicit verification evidence.
Cutover decision: hold or conditional authorisation based on critical blockers, not percentage complete.
Understand Your Migration Readiness Decision
Build a documented inventory, obtain supplier-confirmed commitments and identify unresolved critical blockers before seeking cutover approval.

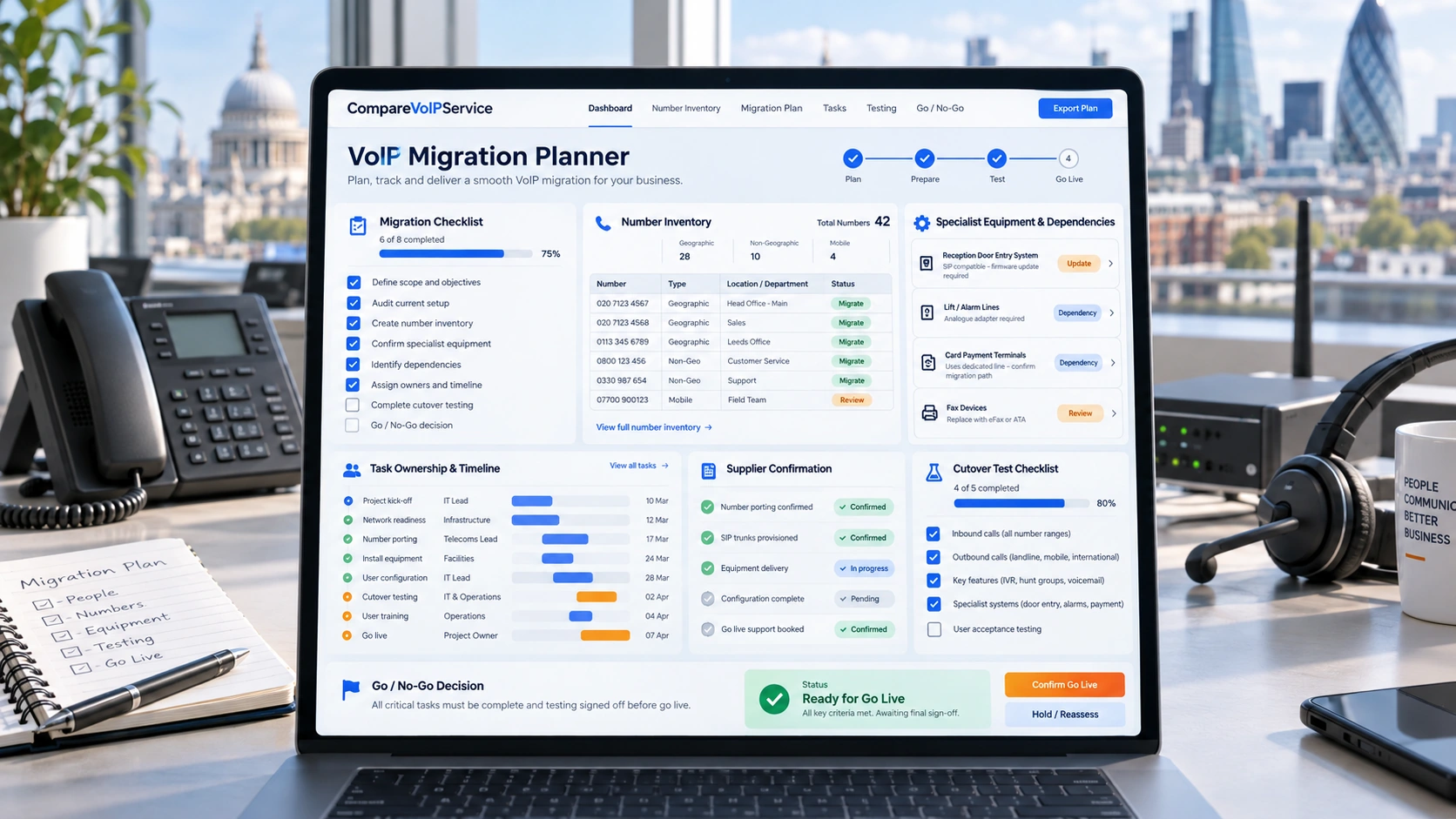

Business Telephone Migration Readiness Planner
Record what is in scope, who owns each dependency and what has been verified. This is a project record, not a confirmation of a porting appointment or certification of safety-related devices.
Cutover Readiness Decision
Review Before the Cutover
Readiness is determined by critical gates, evidence and recorded approval—not a completion percentage. Results reflect only data entered by the user. Do not cease legacy lines or assume number porting, emergency calling, alarms, lift communications or other specialist services are safe without supplier confirmation.
Privacy: this planner runs in your browser. Data is not sent to CompareVoIPService by this form; leaving or refreshing the page may discard it. Open a downloaded HTML report in your browser to print or save it as PDF. Download your report before leaving. Avoid entering unnecessary personal or security-sensitive details.
Critical Equipment Dependencies
Identify alarms, lifts, payment devices, intercoms, fax and telecare systems that may rely on legacy lines.
Provider-Confirmed Number Transfers
A requested date does not prove a port is scheduled. Record the supplier-confirmed appointment and the number inventory.
What Readiness Does Not Guarantee
No browser tool can certify supplier compliance, successful porting or the safety of third-party devices. A user-recorded authorisation remains conditional on genuine external verification.
Build Your Business Telephone Migration Plan
Begin with scope. Identify the locations, numbers, services, people and third parties involved. Then record what depends on the existing telephone connection. Do not assume that every line is used only for voice calls.
| Planning area | Information to establish | Evidence to retain |
|---|---|---|
| Business sites | Each office, branch, remote team or location using the affected service | Site list and service owner |
| Telephone numbers | Main numbers, direct dial-in numbers, departmental lines and special destinations | Verified inventory and current provider records |
| Existing service | Current carrier, PBX, SIP service, analogue line or hybrid arrangement | Service bills, contract references and technical details |
| Number portability | Which numbers the business needs to retain and who can authorise a move | Gaining-provider requirements and written account-holder confirmation |
| Line-dependent devices | Alarm signalling, payment devices, entry systems, lift communications, fax or monitoring equipment where relevant | Device owner, supplier advice and compatibility test plan |
| User access | Desk phones, softphones, mobile apps, headsets and shared devices | User and device inventory |
| Network and power | Router, switches, internet circuits, backup connections and power resilience | Technical readiness evidence and dependency owners |
| Customer call flows | Reception, sales, support, out-of-hours messages and escalation destinations | Agreed routing specification and test calls |
| Migration ownership | Business lead, IT/network owner, existing provider, gaining provider and specialist vendors | Named responsibility and escalation contacts |
| Planned cutover | Proposed date, required lead times, change window and support cover | Confirmed schedule and change approvals |
Build my migration plan
Record The Dependency Before Marking A Task Complete
Every important task should have an owner, a status and evidence. “Supplier contacted” is not the same as “supplier confirmed compatibility and agreed the test”. “Port request submitted” is not the same as “porting date confirmed”.
A simple, dependable status set is Not started, In progress, Waiting for third party, Blocked, Verified complete and Not applicable. Keep blocked items visible until resolved; moving them to a completed column does not remove the risk.
Stage 1: Find Everything Using the Existing Connection
The most costly omissions are often services that are not included in a normal extension list. Investigate numbers and analogue circuits that support equipment rather than staff conversations. Ask the people who operate the relevant site or system, not only the telephone administrator.
| Potential dependency | Why it needs a separate check | Suitable next action |
|---|---|---|
| Fire or intruder alarm signalling | The communicator may depend on a specific connection or signalling method | Obtain advice and test requirements from the alarm or monitoring provider |
| Lift emergency communications | Emergency calling and approved communications arrangements may have particular requirements | Confirm the correct solution with the lift maintainer or specialist provider |
| Telecare or personal alarm equipment | Continuity and safeguarding can be critical | Coordinate with the specialist supplier and follow relevant provider protection procedures |
| Card payment terminal | Some terminals may still use legacy connectivity or have site-specific requirements | Check the payment provider’s approved connection method |
| Building entry or intercom | Door or gate equipment may route calls through the current telephone service | Verify the actual signalling path and replacement compatibility |
| Fax or other data device | Legacy protocols may not operate reliably over the proposed configuration | Establish whether the process must be replaced, retained or tested |
| Broadband or network service linked to a legacy line | Service withdrawal or restructuring could affect internet continuity | Confirm with the connectivity supplier before cancelling anything |
| External call diversion | Critical calls may depend on legacy routing or published numbers | Record and test the intended route before cutover |
Critical principle: do not cancel an existing line because it appears unused on a telephone bill. Confirm the attached service and equipment, including third-party monitoring contracts. Where a device is safety-related, the specialist supplier’s approval and appropriate operational tests are more important than a generic VoIP compatibility claim.
Practical Business Migration Scenarios
Six planning situations that make a critical business dependency more visible than a simple task-completion percentage.
Alarm or Lift Line
01Specialist equipment may still depend on existing circuit connectivity.
- Required evidence
- Specialist sign-off
- Decision
- Hold affected scope
Ask the maintainer for approved replacement and test evidence.
Record This RequirementUnconfirmed Number Port
02A porting request was submitted but no appointment was confirmed in writing.
- Required evidence
- Written confirmation
- Decision
- Hold number cutover
Do not treat a proposed date as a supplier-committed event.
Record This RequirementMain Reception Route
03Staff devices register but the published main number does not reach reception.
- Required evidence
- Successful test call
- Decision
- Hold go-live
Repair routing and retest inbound, overflow and out-of-hours calls.
Record This RequirementInternet or Power Gap
04A branch cannot demonstrate required call capacity or a continuity route.
- Required evidence
- Resilience test
- Decision
- Review / hold
Verify actual network, supported emergency calling and recovery.
Record This RequirementNo Available Incident Lead
05A cutover is proposed without named supplier or business recovery contacts.
- Required evidence
- Change cover
- Decision
- Hold change
Assign an incident owner, escalation path and agreed fallback.
Record This RequirementLower-Risk Open Issue
06A non-critical display preference remains after all customer routes pass.
- Required evidence
- Accepted exception
- Decision
- Conditional review
Document the owner, impact, due date and business acceptance.
Record This RequirementVerify Critical Services Before Cutover
A reliable cutover decision requires provider confirmations, an inventory of all critical lines, specialist sign-offs where needed, representative call tests and an agreed recovery plan.
Confirm Scope and Number Records
Reconcile all main numbers, DDIs and the current supplier records. Make sure the authorised account holder can act.
For critical lines, record proof rather than a general statement that the provider was contacted.
Confirm Specialist Dependencies
Ask relevant alarm, lift, telecare, access or payment suppliers to verify the approved change and required tests.
Never assume an unused-looking number can be cancelled safely.
Cutover Readiness Needs Documented Evidence
A new phone platform may be configured but still be unfit for cutover if critical numbers, specialist equipment, emergency arrangements or recovery have not been confirmed.
Stage 2: Assign Owners and Third-Party Responsibilities
A single migration can involve the business, its IT support provider, connectivity supplier, current telephone operator, replacement operator, alarm specialist and other contractors. Define who is responsible for each activity and who has the authority to stop the change.
| Activity | Accountable decision owner | Required confirmation |
|---|---|---|
| Approve business scope and service priorities | Business project lead | Agreed inventory and critical call routes |
| Verify internet and local network readiness | IT or network owner | Site-specific tests and documented constraints |
| Arrange number transfers | Authorised account holder with gaining provider | Validated number records and supplier-confirmed transfer process |
| Validate specialist equipment | Relevant equipment or monitoring supplier | Compatibility evidence and successful test criteria |
| Configure phones and routing | New telephone provider or implementation team | Approved configuration and test results |
| Confirm user readiness | Department or service owners | Staff access, training and acceptance checks |
| Authorise go-live | Named business change approver | No unresolved critical blockers and accepted evidence |
| Invoke fallback or rollback | Named incident lead | Agreed trigger conditions and supplier participation |
A clear owner is not necessarily the person performing the technical work. Record both where responsibilities are split. Escalation contacts should be available during the change window, not only during normal procurement hours.
Stage 3: Prepare Number Transfers
Telephone number porting is a provider-managed process with its own authorisation, account information and timing requirements. A planned date is not a confirmed porting date. The original range allocation of a telephone number does not establish its current serving provider or guarantee porting eligibility.
Number-Porting Readiness Checks
| Check | Why it matters |
|---|---|
| Inventory confirmed | Prevents an individual DDI or published main number being missed |
| Account holder authorised | Establishes who may request or approve a transfer |
| Current service details reconciled | Reduces the risk of inconsistent carrier or account records |
| Destination service tested | Ensures the receiving setup is ready before numbers move |
| Porting arrangements confirmed in writing | Distinguishes an agreed event from an informal target date |
| Fallback and escalation agreed | Establishes how the business responds if a transfer is delayed or disrupted |
| Customer-facing routing validated | Protects reception, support and important published numbers |
For the rules and mechanics of keeping existing UK numbers, use the number porting guide. The planner’s role is to track whether the relevant requirements have been met for your project, not to promise that a transfer will succeed.
Stage 4: Validate Connectivity, Power and Critical Calls
A cloud telephone system relies on multiple components working together. An internet connection, router, power supply or user device can become a single point of failure. Test the arrangements that matter to the business rather than relying only on platform uptime claims.
| Readiness area | Practical evidence |
|---|---|
| Calling capacity | Peak concurrent-call requirement compared with site-specific network capacity |
| Call quality | Representative inbound and outbound tests under normal business load |
| Internal network | Router, firewall, switching and Wi-Fi behaviour validated for the chosen service |
| Power resilience | Actual availability of powered routers, network equipment and relevant endpoints during interruption |
| Emergency calling | Supplier-confirmed arrangements for calling emergency services and the relevant location information |
| Critical line-dependent equipment | Specialist supplier confirmation and recorded functionality tests |
| Remote workers | A practical test of approved devices, connectivity and access controls |
| Alternate arrangements | Diversion, backup connectivity or other agreed continuity measures tested where feasible |
Ofcom’s guidance on digital voice and access to emergency organisations recognises the importance of continuity during power cuts. The correct measures depend on the service and customer circumstances. Do not treat an ordinary backup battery or mobile phone as a universally sufficient emergency solution without confirmation.
UK Digital Landline Transition Context
The UK telephone industry is phasing out the legacy Public Switched Telephone Network, with the programme aiming for migration by January 2027. Government and Ofcom guidance stresses that customers and services with particular vulnerability or line-dependent equipment need appropriate protections. The network programme is a reason to investigate legacy dependencies early; it does not mean every organisation has the same cutover date or that all existing circuits can be disconnected immediately.
Your migration plan should be driven by the actual services affected, contractual arrangements and supplier-confirmed change events. For an explanation of the broader transition, use the PSTN migration guide.
Stage 5: Apply the Cutover Go/No-Go Decision
The most important outcome of the planner is a credible go / hold decision. Completion should be evidence-based, not a percentage that gives trivial tasks the same weight as emergency communications or the main business number.
Essential Conditions Before Go-Live
| Decision gate | Evidence of readiness | Effect if missing |
|---|---|---|
| Business-critical numbers accounted for | Reconciled number list and approved destinations | Hold until the number and route are resolved |
| Number transfer event confirmed where required | Written supplier confirmation and contact arrangements | Hold if transfer is essential to the planned cutover |
| Critical equipment assessed | Specialist validation and completed test requirements | Hold for unresolved safety-critical dependencies |
| Core call journeys tested | Successful inbound, outbound, overflow and out-of-hours tests | Hold if important callers cannot reach the intended destination |
| Network and continuity validated | Technical evidence and agreed fallback | Hold or reduce scope if capacity or resilience is inadequate |
| People and support ready | Named approval, user briefing and incident contacts | Hold if no responsible team can operate or recover the change |
| Rollback or continuity decision made | Supplier-agreed procedure and trigger criteria | Hold if failure could leave critical services without an acceptable alternative |
Not every open issue prevents a migration. A low-impact cosmetic change may be acceptable after go-live. The distinction is whether an unresolved issue affects critical services, safety, availability, legal obligations or the ability to recover from failure.
A Practical Go/No-Go Decision Tree
Is an emergency, alarm or other safety-related dependency unresolved? Do not proceed with the affected cutover until the appropriate specialist has confirmed the arrangements.
Is a business-critical number missing from the confirmed transfer plan? Hold the dependent move and reconcile the inventory with the relevant provider.
Has the new call route failed an acceptance test? Fix and retest it; do not assume it will behave differently after go-live.
Can the change team respond if service is disrupted? If the incident lead, supplier contacts or continuity route are unavailable, reconsider the timing.
Are critical conditions evidenced and accepted? Authorise the defined scope, record the decision and monitor the service during the agreed change window.
Stage 6: Test Customer and Staff Call Journeys
Technical registration alone does not show that the business can handle calls. Use representative scenarios and record the observed outcome.
| Test | Expected business result | Evidence to capture |
|---|---|---|
| Call the main published number | Reception or nominated team answers as specified | Destination, call behaviour and test result |
| Dial department and individual numbers | Calls reach the correct teams or users | Number tested and actual destination |
| Put the first team out of service | The agreed overflow or fallback works | Routing behaviour and any recovery gap |
| Call outside business hours | The correct announcement or destination responds | Scheduled-rule evidence |
| Make an outbound call | The call connects as intended with correct calling identity where supported | Called destination and relevant display/CLI result |
| Test remote or mobile users | Approved users can call and receive calls in intended environments | Device and connection tested |
| Exercise agreed continuity arrangements | Critical call handling remains acceptable in the defined scenario | Supplier-supported test and outcome |
| Confirm specialist devices | Each affected device meets its own acceptance test | Specialist’s approval or recorded test evidence |
Keep actual caller personal data out of shared planning documents unless necessary and appropriately controlled. A test record generally needs the service, expected behaviour, result and responsible reviewer—not a collection of customer contact details.
Stage 7: Prepare Recovery and Post-Cutover Review
A rollback is not simply “switch the old phone system back on”. Number transfers, account changes and service cease orders may not be instantly reversible. Agree realistic continuity steps with the providers before the change and document which actions are actually possible.
Recovery Planning Questions
Who can declare an incident? Which customer numbers are affected? How will urgent calls be handled while the issue is investigated? Which supplier can change routing, and under what conditions? How will staff learn of the temporary process? How will the business confirm that normal service has been restored?
After go-live, verify the important customer routes again, record open issues, retain supplier escalation contacts and set an ownership date for closing outstanding tasks. A cutover is complete when the accepted service is working—not merely when the change window has ended.
Number-Porting Readiness
Confirm the gaining provider has validated the number list, current service details, account authorisation and receiving configuration.
Use the UK Number Porting Guide for the provider-led process.
Safety-Related Devices
For alarms, lift emergency systems and telecare, obtain the competent specialist’s confirmation and appropriate test evidence before moving the affected service.
Unresolved safety-critical equipment is a cutover blocker.
Record affected numbers, locations and specialist devices. Review dependencies.
Obtain supplier confirmations and test critical routes. Check evidence.
A named change approver reviews all critical gates. Review decision gates.
BEFORE CUTOVER
Make the Cutover Decision Visible Before the Change Window
Account for every critical business number, obtain specialist approval where needed, confirm provider commitments in writing and protect customer call journeys. When essential evidence is missing, hold the affected change rather than relying on a completion percentage.
FAQs
Answers about number transfers, line-dependent equipment, business continuity, cutover approval and the limits of a migration readiness assessment.
An Evidence-Led Migration Record
The project plan is more useful when a leadership team can see unresolved blockers without reading every technical message.
| Record | Business value |
|---|---|
| Inventory of sites, numbers and devices | Establishes what is actually in scope |
| Named task owners and due dates | Makes dependencies and accountability visible |
| Supplier confirmations | Separates promises from confirmed external commitments |
| Test results | Shows which operational journeys have been proven |
| Critical blocker list | Prevents readiness percentages hiding serious gaps |
| Change window and authorised decision | Captures what was approved and by whom |
| Recovery arrangements | Records the response if essential communications fail |
| Post-cutover review | Ensures outstanding issues remain owned after launch |
This is not a substitute for a supplier-approved change plan, specialist equipment advice, appropriate safety procedures or required regulatory checks. It is a structured record to make those obligations easier to manage.
Make the Cutover Decision Visible Before the Cutover Day
The most reliable migration plan is the one that shows both completed tasks and the evidence still missing. Account for every critical number and connection, obtain specialist confirmation for dependent equipment, verify the customer journey and give a named decision-maker the authority to hold the change when necessary.
PSTN migration guide · Number porting guide · VoIP Bandwidth Calculator · VoIP setup guide
Sources and Safety Context
This planning approach reflects the separation between technical tasks, supplier confirmation and operational sign-off. UK digital landline transition and customer-protection context is informed by Ofcom and UK government guidance. Specialist equipment and emergency arrangements always require confirmation from the responsible supplier or competent specialist; no generic checklist can certify them remotely.
Safety, service and data limitations: This independent planner records user-entered project details. It cannot certify third-party equipment, emergency calling or the correctness of a porting date. Consult the competent specialist and provider. Do not cancel existing lines before dependencies are confirmed. No personal data is submitted by the browser-side planner; downloaded reports are saved to your device.
Related guidance: PSTN Migration Guide, UK Number Porting Guide and VoIP Setup Guide.
